Modernisation is a choice about which constraints to remove and how much change the operation can absorb. Extending, migrating and rebuilding are different responses; none should be selected solely because the current platform is old.
Begin with evidence of the problem: release delays, difficult integrations, operating incidents, unmet requirements or costs that cannot be explained. Establish a baseline before comparing solutions.
Find the constraint worth addressing
Map the affected workflows and dependencies. Distinguish a product gap from an operational process failure or a contractual restriction. A software rewrite will not automatically solve unclear ownership or supplier access limits.
Record the effect on customers, staff and business objectives. Identify which assumptions can be tested before committing to a large programme.

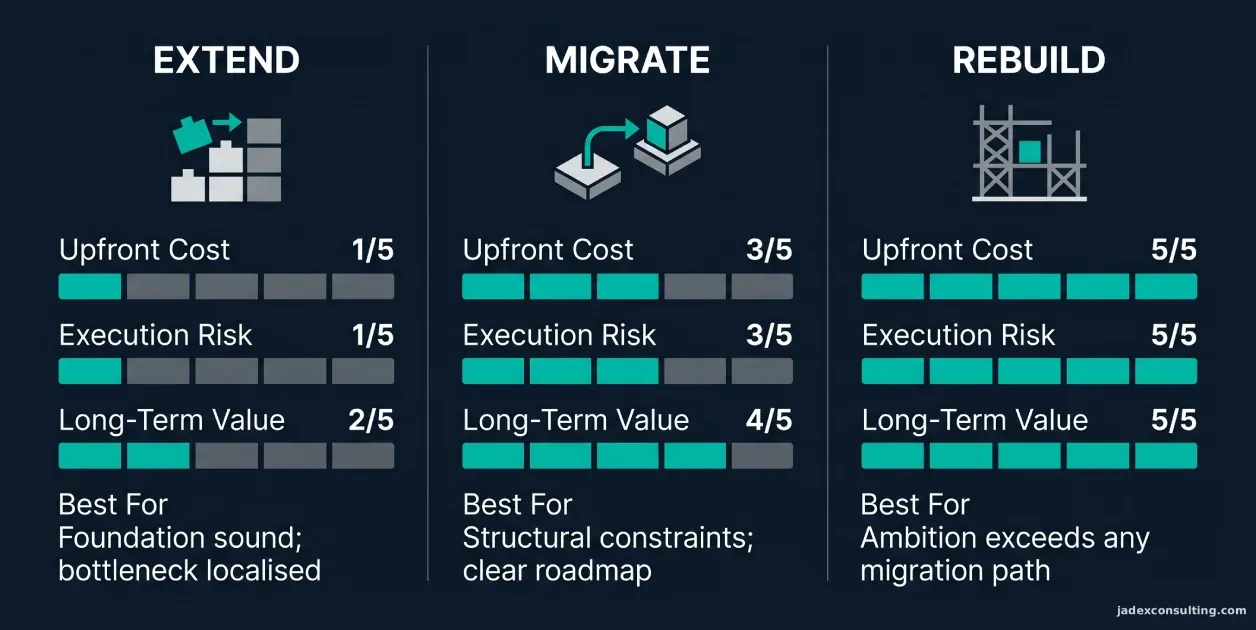

Compare three paths
| Path | Suitable question | Main exposure |
|---|---|---|
| Extend | Can a bounded addition remove the constraint without destabilising the core? | More dependency on existing interfaces and behaviour. |
| Migrate | Does another product or component meet the requirement with manageable transition work? | Data transformation, integration changes and operational cutover. |
| Rebuild | Are essential requirements poorly served by the available alternatives? | Delivery uncertainty and sustained operating responsibility. |
Document assumptions and alternatives. A simple diagnostic score cannot establish which path is right: severe integration complexity, limited team capacity and commercial urgency can point in different directions.
Consider incremental replacement
Where dependencies allow, replace a bounded capability while the old system continues to operate. Define the interface, route a controlled scope of work to the replacement and retain a recovery path.
The strangler fig pattern is one documented approach. It requires suitable boundaries and careful coexistence; incremental migration is not automatically simpler or cheaper than a replacement.
Rehearse the transition
- Map source data, transformations and reconciliation rules.
- Agree how in-flight sessions, payments and restrictions are handled.
- Test cutover, recovery and the conditions for stopping the change.
- Define how both systems are monitored during coexistence.
- Verify that the old system can be retired, not merely left running indefinitely.
Involve the people who operate the platform and respond to incidents. A successful data copy is only part of a working migration.
Compare the full operating commitment
Model delivery, parallel operation, supplier changes, support and retirement over the same horizon. Use scoped estimates rather than universal savings percentages or revenue thresholds.
Set milestones around validated outcomes and review the plan when evidence changes. See the TCO framework and the capability model for the surrounding decisions.
